Schedule & Meetings

Fish Creek Trail Connection Project

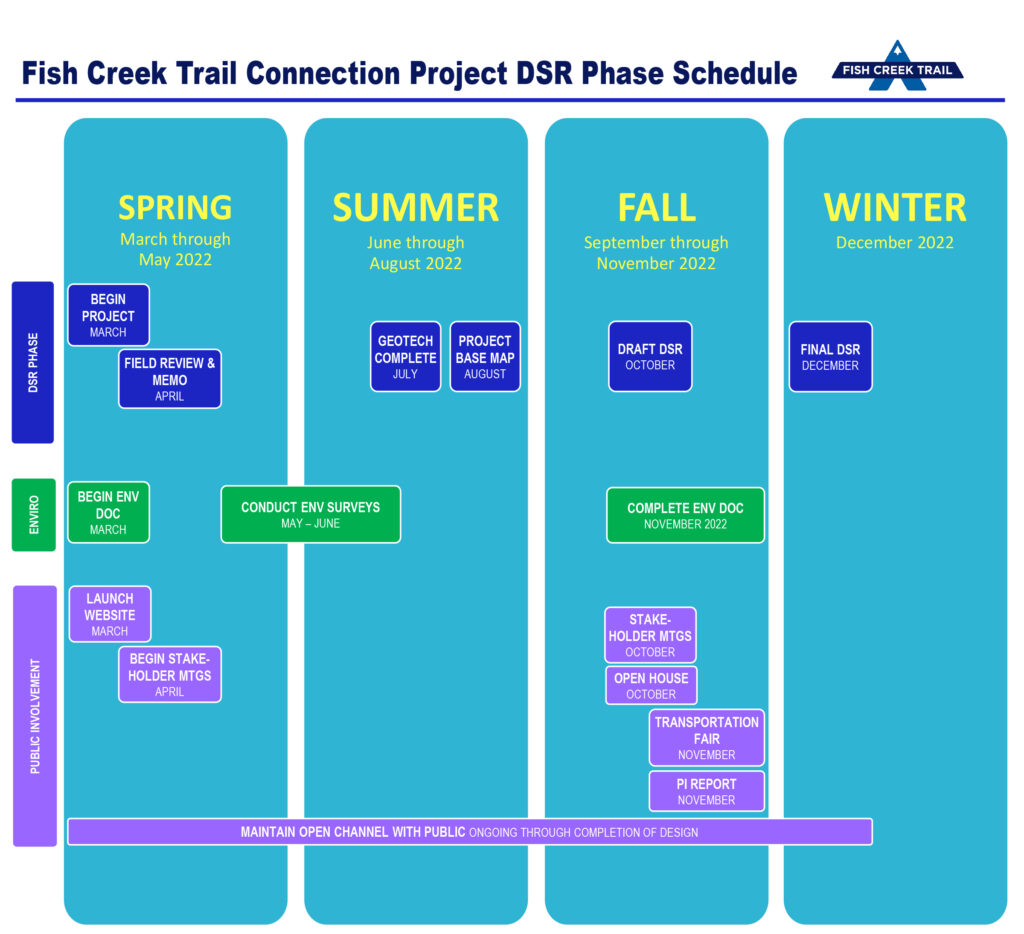

Project Milestones and Schedule through DSR Phases

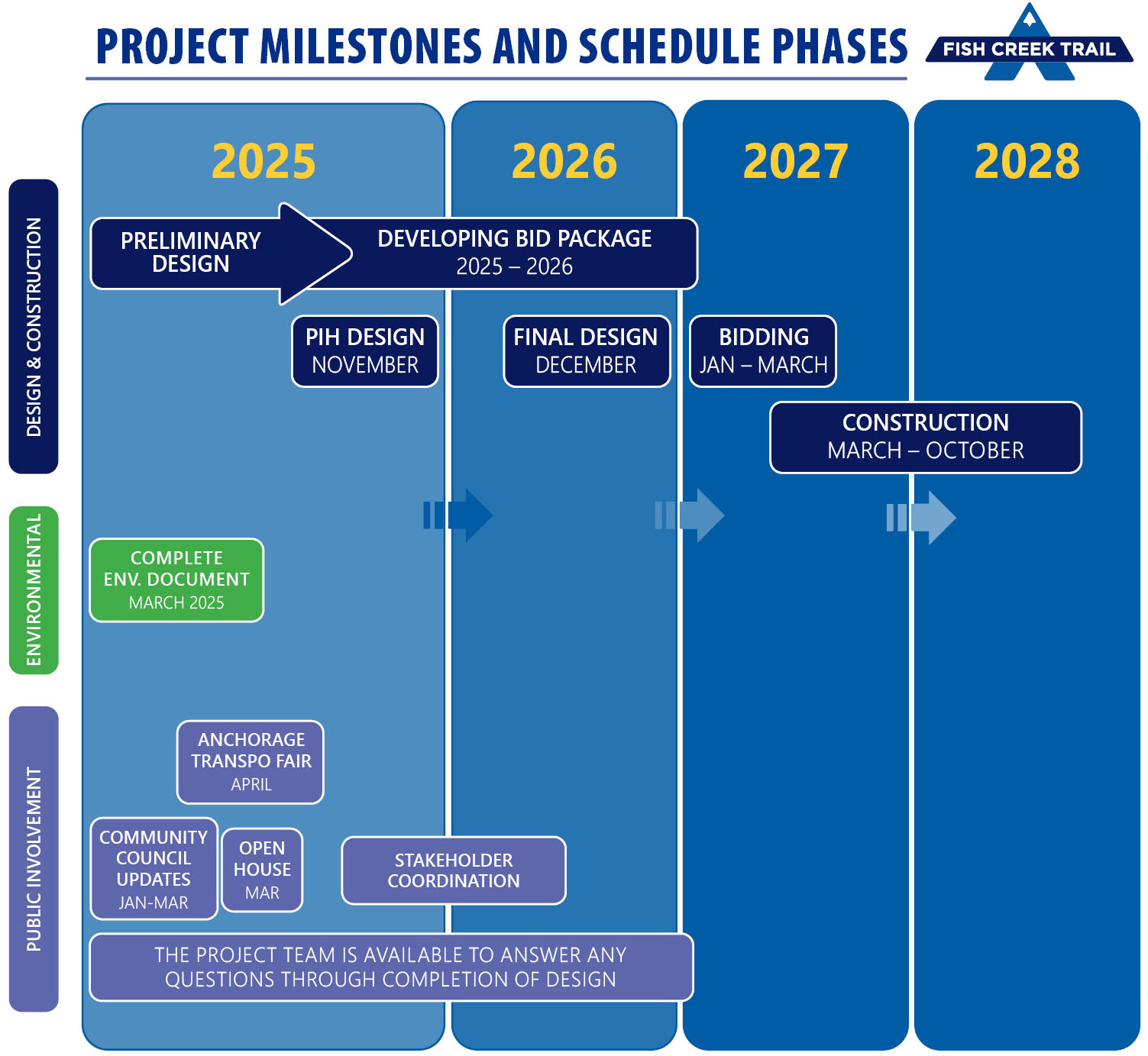

Key project milestones are described below from project kick off in spring 2022 through completion of the Design Study Report (DSR) in winter 2022. Additional design work will occur after 2022.

Spring 2022

  • Kick Off Project
  • Launch Website
  • Begin Stakeholder Meetings
  • Conduct Field Reviews and Complete Field Review Memo
  • Conduct Environmental Studies

Summer 2022

  • Continue Environmental Studies
  • Complete Geotechnical Studies
  • Create Project Base Map

Fall 2022

  • Complete Environmental Document
  • Complete Draft Design Study Report (DSR)
  • Host Informational Booth at Anchorage Transportation Fair
  • Hold Public Open House Meeting

Winter 2023

  • Complete Final DSR

Ongoing public involvement will occur for this project including: project notices (mailer, advertisement) and stakeholder and public meetings. Notices will be sent out before each public meeting announcing date, time, and venue.
